2025 Pavement Overlays

Project Summary

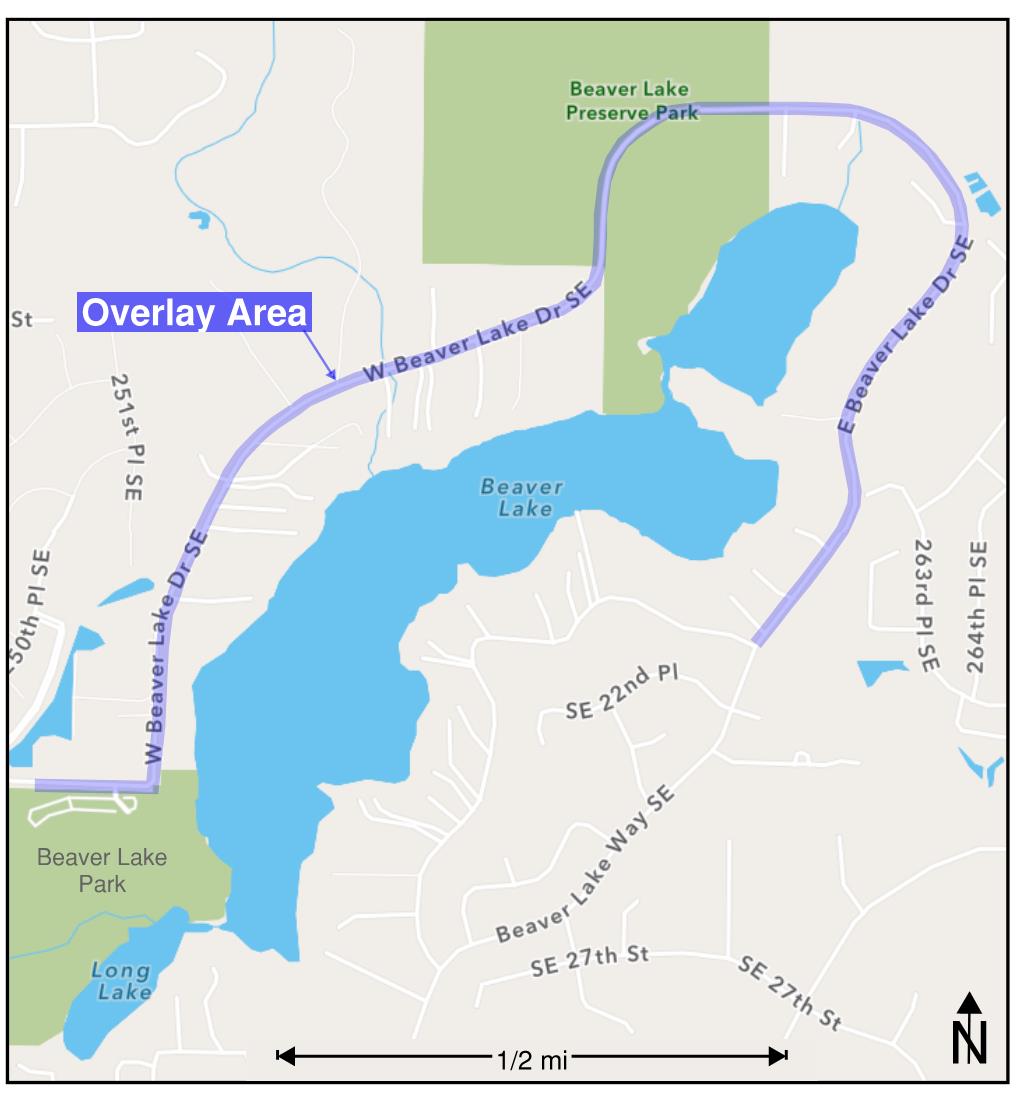

The City of Sammamish 2025 Overlay Project will replace the top pavement layer on a 1-mile-long section of East/West Beaver Lake Drive SE. The major items of work include the removal of the top layer of existing pavement, pavement repairs, and the placement of a new layer of hot-mix-asphalt pavement and new roadway markings.
This project is part of the City of Sammamish Pavement Management Program, which provides major street maintenance of roadways. This maintenance include street overlays, pavement rehabilitation, curb and sidewalk repair and appropriate Americans with Disabilities (ADA) retrofit work. Pavement overlay projects also replace pavement markings and vehicle detection loops for traffic signals. For more information on the Pavement Management Program, visit the link below.
https://www.sammamish.us/projects/pavement-management
Project Timelime
The timeline below is approximate and is subject to change.
Milestone |
Anticipated Date |
Project Initiation |
September - October 2024 |
Pre-Engineering |
November - December 2025 |
Design |
January - April 2025 |
Bidding & Contract Negotiations |
May 2025 |
Pre-Construction |
June 2025 |
Construction |
July 2025 |
Project Closeout |
August 2025 |
Construction Information
Construction Schedule
Updated August 1, 2025
We are pleased to report that all construction work for the 2025 Pavement Overlays Project has been successfully completed. The project is now in the closeout phase, during which final documentation, inspections, and administrative requirements will be addressed to ensure full compliance and formal completion.
Work Description |
Dates |
Site Preparation & Notifications |
June 26 – July 3 |
Asphalt Grinding |
July 7 |
Asphalt Overlays |
July 10 – July 14 |
Utility Adjustments |
July 21 – July 22 |
Property/Shoulder Restoration |
July 24 – July 25 |
Roadway Channelization (Striping, Signs) |
July 28– July 29 |
Hours of Work
Construction generally starts at 7:00 am and ends at 5:00 pm, daily. Actual start and end times may vary slightly depending on construction progress. If paving continues into the school year (August 29th), working hours will be changed to 9:30 am to 3:30 am.
Traffic Control
Most streets will remain open throughout most of the construction, but traffic will be reduced to a shared lane controlled by flaggers. There will not be enough room for U-turns in the work zones so drivers wanting to turn around will need to travel to the next traffic signal outside of the work zone.
Driveway Access
Most of the time, driveways and intersections will remain open. In cul-de-sacs, crews will work with the residents to temporarily close the cul-de-sac so that paving operations can be completed quickly. During the actual paving process, there is typically a two-to-three-hour time period where access to driveways is not allowed. This is time needed for the pavement to cool and harden before traffic can drive on it.
On-Street Parking
On the days of construction, on-street parking will need to be restricted. Signs will be posted in advance of the work to notify residents of the parking restrictions.
Waste & Recycling Schedule
The waste and recycling schedule will not be changed due to construction. When days of paving and waste collection coincide, we work with the collection service to adjust their route schedule and focus first on the streets that are being paved. If there is construction in your neighborhood, please be sure to have your waste and recycling out extra early.
School Bus Routes
If construction continues into the school year, school bus routes and schedule will not be changed. We will be working with the paving contractor and local school districts to ensure unimpeded service in all neighborhoods.
Tree Trimming
Tree trimming may need to be done in front of your house. If there is vegetation in front of your property that extends out into the street, it will need to be pruned back to allow the equipment to do the street resurfacing. Please trim the vegetation along your property if this is the case. City crews or the Contractor will trim vegetation as needed for the project. However, they will only be doing the minimum needed to clear the road for paving and some additional trimming may need to be completed afterwards by the adjacent property owner.
Street Cuts
Ordinance #02001-78 prohibits the excavation of resurfaced or newly constructed roads for a minimum of five years following construction or paving. If you are planning to have any underground utility work done, such as water, sewer, telephone, gas, electrical, etc., you are strongly encouraged to expedite this work if it involves utility work under the new pavement. Please call us as soon as possible to coordinate this work.
