2026 Pavement Overlays Project
Construction Schedule
Construction began on August 3, 2026, and is anticipated to continue through October 19, 2026. The schedule is highly weather-dependent and may change as construction progresses.
Key anticipated activities include:
-
Initial site preparation, utility lowering, and concrete and pavement repairs:
-
August 3–25
-
-
Issaquah-Pine Lake Road SE night work:
-
Pavement planing: August 17–19
-
Asphalt paving: August 20–25
-
-

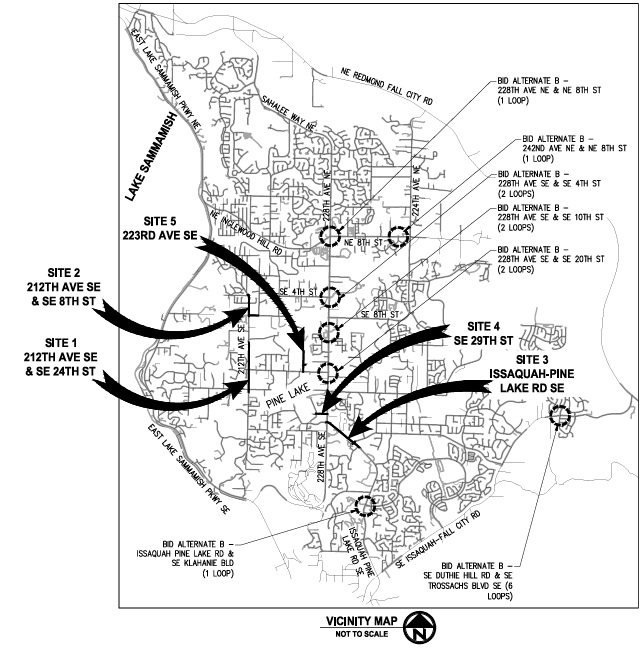

212th Avenue SE, SE 8th Street, 223rd Avenue SE, and SE 29th Street:
-
Pavement planing: August 26–September 1
-
Asphalt paving: August 28–September 15
-
-
Utility adjustments, pavement markings, signing, and traffic-loop work:
-
Continuing through October 19
-
Additional schedule updates will be posted as construction progresses.

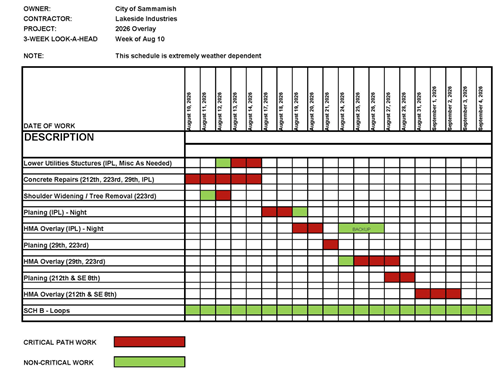

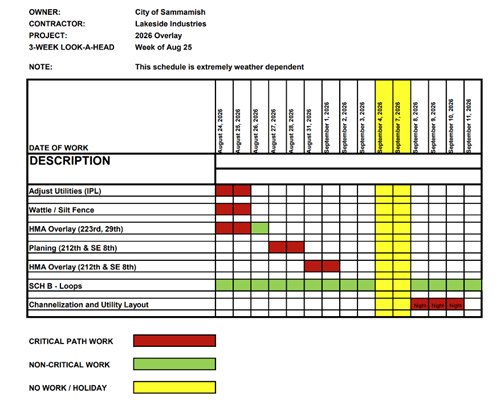

Update 8/12/26:
Project Summary

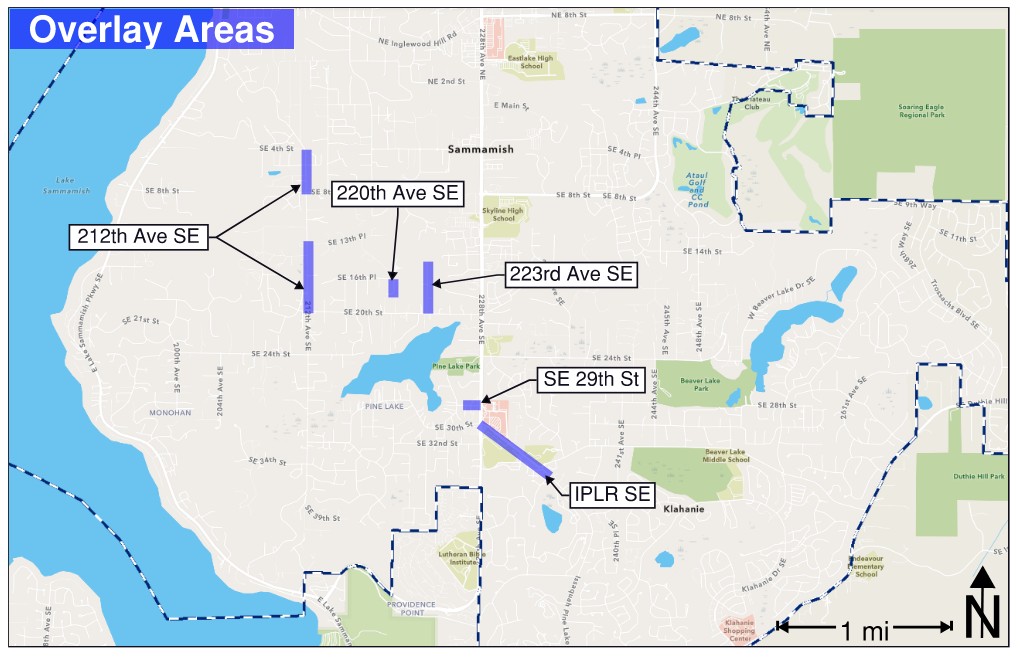

The City of Sammamish 2026 Overlays Project will resurface pavement on four streets throughout the City:
- 212th Avenue SE: from SE 24th Street to SE 14th Place, and SE 8th Street to SE 4th Street
- Issaquah-Pine Lake Road SE: from 228th Avenue SE to 234th Avenue SE
- SE 29th Street: from 228th Avenue SE to 226th Avenue SE
- 223rd Avenue SE: from SE 20th Street to the north end of the road
The major items of work include the removal of the top layer of existing asphalt, subbase repairs, the placement of new hot-mix-asphalt pavement, and the installation of new roadway markings. Adjacent pedestrian curb ramps will also be upgraded to meet ADA compliancy.
This project is part of the City of Sammamish Pavement Management Program, which provides major street maintenance of roadways. This maintenance include street overlays, pavement rehabilitation, curb and sidewalk repair and appropriate Americans with Disabilities (ADA) retrofit work. Pavement overlay projects also replace pavement markings and vehicle detection loops for traffic signals. For more information on the Pavement Management Program, visit the link below.
https://www.sammamish.us/projects/pavement-management
Project Timelime
The timeline below is approximate and is subject to change. Please continue to check the project website for updates.
|
Milestone |
Anticipated Date |
|
Project Initiation |
January 2026 |
|
Design |
February - May 2026 |
|
Bidding & Contract Negotiations |
May - June 2026 |
|
Pre-Construction |
August 2026 |
|
Construction |
August - October 2026 |
|
Project Closeout |
Q4 2026 |
